Key takeaways
- Utility scale battery storage projects typically deploy lithium iron phosphate (LFP) chemistry at containerised energy densities exceeding 300 kWh/m².
- A 20 MW, 4-hour system requires approximately 115.6 MWh of initial nameplate DC capacity to guarantee 80 MWh AC export at year 15 under 1.0 daily cycle degradation.
- Modern utility scale BESS designs favour liquid-cooled thermal management, maintaining cell temperature differentials under 3°C to limit capacity divergence.
- NFPA 855 and UL 9540A mandate 3.1-metre (10-foot) separation between containers unless full-scale fire testing verifies non-propagation at closer spacing.
- Interconnection through dedicated medium-voltage step-up transformers requires electrostatic shielding and low-voltage winding isolation to mitigate inverter switching harmonics.

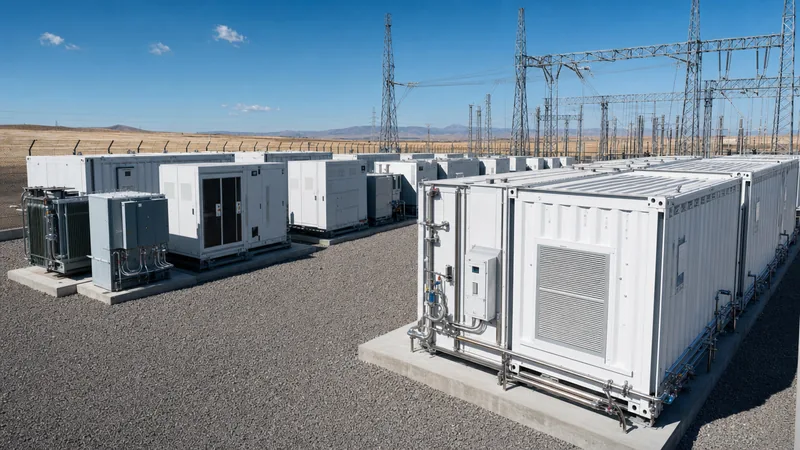

Quick answer: A utility scale battery storage installation is an electrochemical energy storage facility, typically rated between 10 MW and over 1,000 MW, engineered to supply wholesale capacity, transmission congestion relief, and primary frequency response to the electrical grid. These systems integrate containerised battery racks, bidirectional power conversion systems, liquid thermal loops, and medium-voltage grid step-up transformers into a centralised generation asset.
Front-of-the-meter (FTM) energy storage has transitioned from demonstration pilots to central infrastructure for transmission system operators (TSOs) and regional grid operators. Deploying high-availability utility scale battery energy storage systems requires rigorous multi-domain engineering across high-voltage insulation coordination, thermal run-rate suppression, and cycling degradation models. System designs must align with IEC 62933-5-2 for system safety and IEEE 2800 for grid interconnection compliance to ensure bankability and long-term operating life.
Architecture of Utility Scale Battery Energy Storage Systems
A modern utility scale battery energy storage system is structured around four primary subsystems: the DC battery block, the bidirectional power conversion system (PCS), the auxiliary thermal balance-of-plant, and the medium-voltage substation skid. At the core, 3.2 V lithium iron phosphate (LFP) cells are wired in series to create battery modules, which are stacked into 1,500 V DC battery racks. Operating at 1,500 V DC reduces balance-of-system cabling cross-sections and minimizes $I^2R$ conduction losses across the DC bus compared to legacy 1,000 V architectures.
Racks are grouped into standardized 20-foot or 40-foot container enclosures equipped with intelligent battery management systems (BMS). Multiple containers connect to centralized or modular string power conversion systems, which convert the direct current into three-phase alternating current at voltages between 600 V and 690 V AC. For an in-depth breakdown of conversion topologies, refer to our Power Conversion System Guide. These inverter skids interface directly with dedicated oil-immersed step-up transformers housed within containerised or skid-mounted sub-stations, raising the voltage to 22 kV, 33 kV, or 34.5 kV for site collection networks before feeding the main grid substation.
Sizing and Degradation Calculation for a Utility Battery Plant
Sizing a utility battery installation requires calculating initial overbuild capacity to offset cycle-induced cell degradation, auxiliary consumption, and conversion losses over the project lifespan.
Consider a utility contract specifying a 20 MW continuous export for a 4-hour discharge duration (80 MWh usable AC delivery at the point of common coupling) at Year 15, operating at 1 equivalent full cycle (EFC) per day (365 cycles/year, totaling 5,475 cycles). Assume the following operational parameters:
- System round-trip efficiency (RTE) inverter-to-grid: 96.5% discharge efficiency (PCS + transformer).
- Operational depth of discharge (DoD): 90% (operating window between 5% and 95% state of charge).
- LFP cell end-of-life (EoL) capacity retention: 72% at 5,475 cycles at 25°C average cell temperature.
- Auxiliary parasitic load during discharge (HVAC, pumps, controls): 2.5% of total exported energy.
Calculate the required nameplate DC capacity ($E_{nameplate}$) using the step-by-step formula below:
- Determine required AC gross discharge energy including auxiliary loads:
E_{gross, AC} = 80 MWh / (1 - 0.025) = 82.05 MWh - Calculate energy required from the DC side through the PCS and transformer:
E_{gross, DC} = 82.05 MWh / 0.965 = 85.03 MWh - Account for the allowable operational DoD window:
E_{usable, DC} = 85.03 MWh / 0.90 = 94.48 MWh - Factor in Year-15 cell degradation to establish day-one DC nameplate rating:
E_{nameplate} = 94.48 MWh / 0.72 = 131.22 MWh
The plant requires an initial installed DC capacity of 131.22 MWh, representing an overbuild factor of 1.64 relative to the 80 MWh AC delivery requirement, or alternatively, an augmentation strategy adding 10-15 MWh at years 5 and 10.
Technical Comparison: System Configurations in Utility Energy Storage
Selecting between centralised and decentralised power electronics, as well as air and liquid thermal management, directly dictates capital expenditure, round-trip efficiency, and container energy density.
| Engineering Metric | Centralised Inverter (Air Cooled) | Centralised Inverter (Liquid Cooled) | String Inverter (Liquid Cooled) |
|---|---|---|---|
| DC Bus Voltage (V DC) | 1,000 to 1,500 | 1,500 | 1,500 |
| System Energy Density (MWh per 20ft ISO) | 2.5 - 3.4 | 4.5 - 5.0 | 4.5 - 5.0 |
| Cell Delta-T across Module (°C) | ±4.0 to ±6.0 | ±1.5 to ±2.5 | ±1.5 to ±2.0 |
| Auxiliary Power Consumption (%) | 4.0 - 6.5 | 2.0 - 3.2 | 2.2 - 3.5 |
| PCS Unit Rating (kVA) | 2,500 - 4,000 | 2,500 - 4,000 | 175 - 300 |
| Fault Current Contribution (kA per skid) | Higher (consolidated) | Higher (consolidated) | Lower (distributed) |
| Availability Impact on Single Fault | Entire block off-line | Entire block off-line | Only string offline (<5%) |
As indicated in the operational data, modern utility energy storage projects overwhelmingly deploy liquid-cooled energy storage containers. Liquid cold-plate cooling eliminates localized hot spots, limiting cell degradation scatter and preserving system warranty terms under high C-rate cycling regimes.
Thermal Management and Fire Safety Compliance for Utility Scale BESS
Thermal runaway prevention and containment define the engineering perimeter of any utility scale bess installation. The dominant thermal management approach couples internal module cold plates using a 50/50 water-glycol mixture to external chillers and dry coolers. For deeper analysis of thermal sizing, see our technical article on Battery Cooling Systems. Keeping internal cell-to-cell thermal variations under 2.5°C prevents premature capacity fade and unbalance across series-connected cell groups.
Fire protection compliance requires strict adherence to NFPA 855 (Standard for the Installation of Stationary Energy Storage Systems) and IEC 62933-5-2. Key compliance design criteria include:
- UL 9540A Testing: Large-scale fire test reports must demonstrate that thermal runaway does not propagate from cell to cell within a module, module to module within a rack, or rack to adjacent racks without intervention.
- Deflagration Venting: Compliance with NFPA 68 requires calculated roof-mounted blast vents designed to vent off-gases (primarily carbon monoxide, hydrogen, and methane) at a predetermined relief pressure (typically 20 to 50 kPa) prior to structural container rupture.
- Gas Detection Interlocks: Multi-gas aspirated sampling detection (monitoring $CO$, $H_2$, and volatile organic compounds) linked to BMS trip circuits to open string DC contactors before thermal onset reaches runaway thresholds.
- Separation Distances: NFPA 855 Table 4.4.2 mandates a minimum of 3.1 metres (10 feet) between individual energy storage containers and between containers and exposed buildings or property lines, reducible only when UL 9540A unit-level testing proves fire containment.
Site planners should consult our comprehensive BESS Siting and Location Guide for setback, access road, and containment footprint requirements.
Grid Interconnection and Substation Integration
Grid interconnection for utility scale battery storage requires specialised electrical equipment capable of withstanding bidirectional power flow, rapid ramp rates, and rich harmonic spectra produced by high-frequency switching. Inverter skids connect directly to the low-voltage windings of dedicated oil-immersed medium-voltage transformers. These transformers must feature an electrostatic shield between primary and secondary windings to suppress high-frequency capacitive coupling and ground-current circulation generated by insulated gate bipolar transistor (IGBT) pulsing.
Furthermore, grid codes aligned with IEEE 2800-2022 and ENTSO-E require utility scale battery systems to provide continuous active power frequency response (primary frequency control) within 200 to 500 milliseconds of a grid transient, as well as fast reactive power ($Q$) injection for dynamic voltage support. Substation design requires incorporating medium-voltage circuit breakers rated for DC offset saturation caused by close-coupled battery inverters, alongside intelligent protection relays implementing directional overcurrent (ANSI 67), rate of change of frequency (ANSI 81R), and loss of mains (ANSI 78) protections.
Quality Inspection and Pre-Commissioning Checklist for Utility Scale Battery Storage
Field commissioning of utility scale battery storage assets must follow a structured quality verification sequence prior to dynamic grid energisation. Factory acceptance testing (FAT) records from the manufacturing facility must be reconciled with on-site inspection data.
- DC Isolation and Hi-Pot Testing: Conduct insulation resistance testing on all 1,500 V DC buses and rack feeder cables at 2.5 kV DC per IEC 60364-6, confirming resistance values exceed 100 MΩ.
- Liquid Loop Pressure and Coolant Purity: Pressure-test the cooling loop at 1.5 times the operational design pressure (typically 4.0 to 6.0 bar) for 4 hours; verify glycol refractometer concentration reading is 50% ± 2% and loop electrical conductivity is below 10 μS/cm.
- BMS Telemetry and Contactor Trip Logic: Simulate under-voltage (2.5 V), over-voltage (3.65 V), and over-temperature (55°C) thresholds across every module sensor channel to verify hardware interlocks trip the DC contactors within 15 milliseconds.
- Step-Up Transformer and Switchgear Phasing: Perform turns ratio (TTR), winding resistance, and vector group verification per IEC 60076-1 on the medium-voltage skid; verify phase rotation matches the substation busbar via synchronising relays prior to breaker closure.
- Fire Suppression and Gas Purge Integration: Functionally test aerosol or Novec 1230 discharge heads, dry pipe deluge connection lines, and automatic louvre closing sequences on the container thermal barrier.
Next steps: specifying and sourcing
When specifying equipment for a utility scale battery storage facility, project engineers should prepare a comprehensive single-line diagram, site climatic envelope, desired cycle life profile, and point-of-interconnection voltage parameters. Specifying factory-integrated solutions ensures mechanical, thermal, and electrical compatibility across all stages. Explore our integrated energy storage systems, high-density liquid-cooled ESS containers, and MV skid transformer substations to match your system capacity. To discuss technical specifications, submit an RFQ, or review factory test certifications, reach out to our engineering team directly via our contact page or request a project quotation on our quote page.
Frequently asked questions
What is the typical lifespan of a utility scale battery storage system?
A utility scale battery storage system typically operates for 15 to 20 years. System life depends on daily cycle count, depth of discharge, and cell operating temperature, with capacity augmentation usually performed at years 7 to 10 to sustain output.
Why is LFP preferred over NMC in utility energy storage?
LFP chemistry is preferred due to its superior thermal stability, longer cycle life (typically 5,000 to 8,000 cycles versus 2,500 to 4,000 for NMC), and lower capital cost per cycle, making it ideal for stationary grid installations where gravimetric energy density is not critical.
What does a 4-hour utility scale battery mean?
A 4-hour battery can discharge at its continuous rated power output for 4 consecutive hours before reaching minimum charge. For example, a 50 MW / 200 MWh system supplies 50 MW continuously for 4 hours, providing 200 MWh of usable energy.
How much land does a utility scale battery storage facility require?
A standard containerised utility battery installation requires approximately 1 acre (4,000 square metres) per 20 MW to 40 MW of 4-hour storage. This footprint includes mandatory NFPA 855 access roads, physical separation buffers, inverters, and medium-voltage transformer substations.
What is the round-trip efficiency of a utility scale BESS?
The AC-to-AC round-trip efficiency of a utility scale BESS typically ranges from 85% to 89%. This efficiency accounts for electrochemical battery losses, bidirectional inverter conversion losses, auxiliary cooling equipment consumption, and medium-voltage step-up transformer losses.
